A truck goes through four core processes from steel plate to final assembly: Stamping → Welding → Painting → Final Assembly. Let me walk you through how this is done in a modern truck factory.

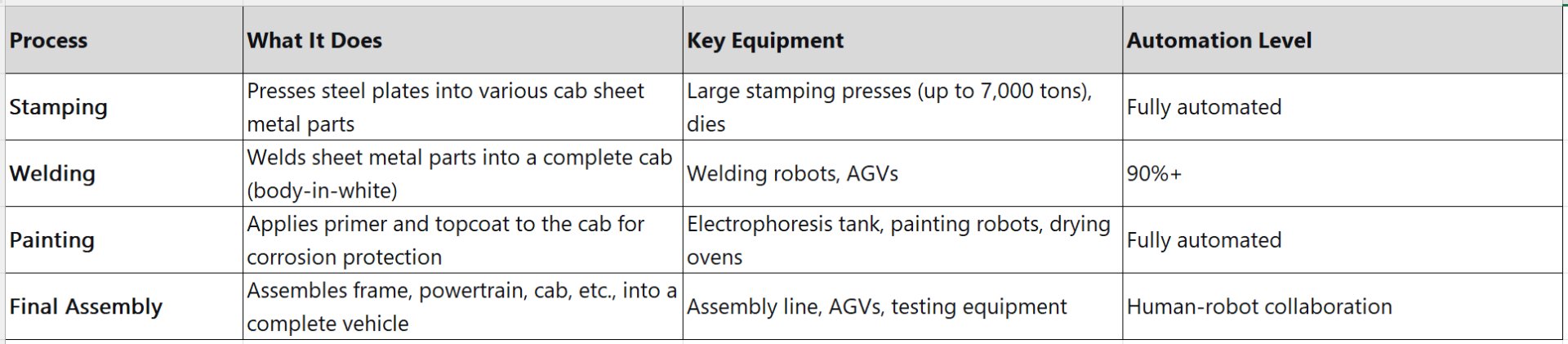

I. Overview of the Four Core Processes
![]()
???? Modern factory efficiency: Advanced heavy truck factories in China can produce one heavy truck every 4 minutes, with delivery times as short as 5 days from order placement.

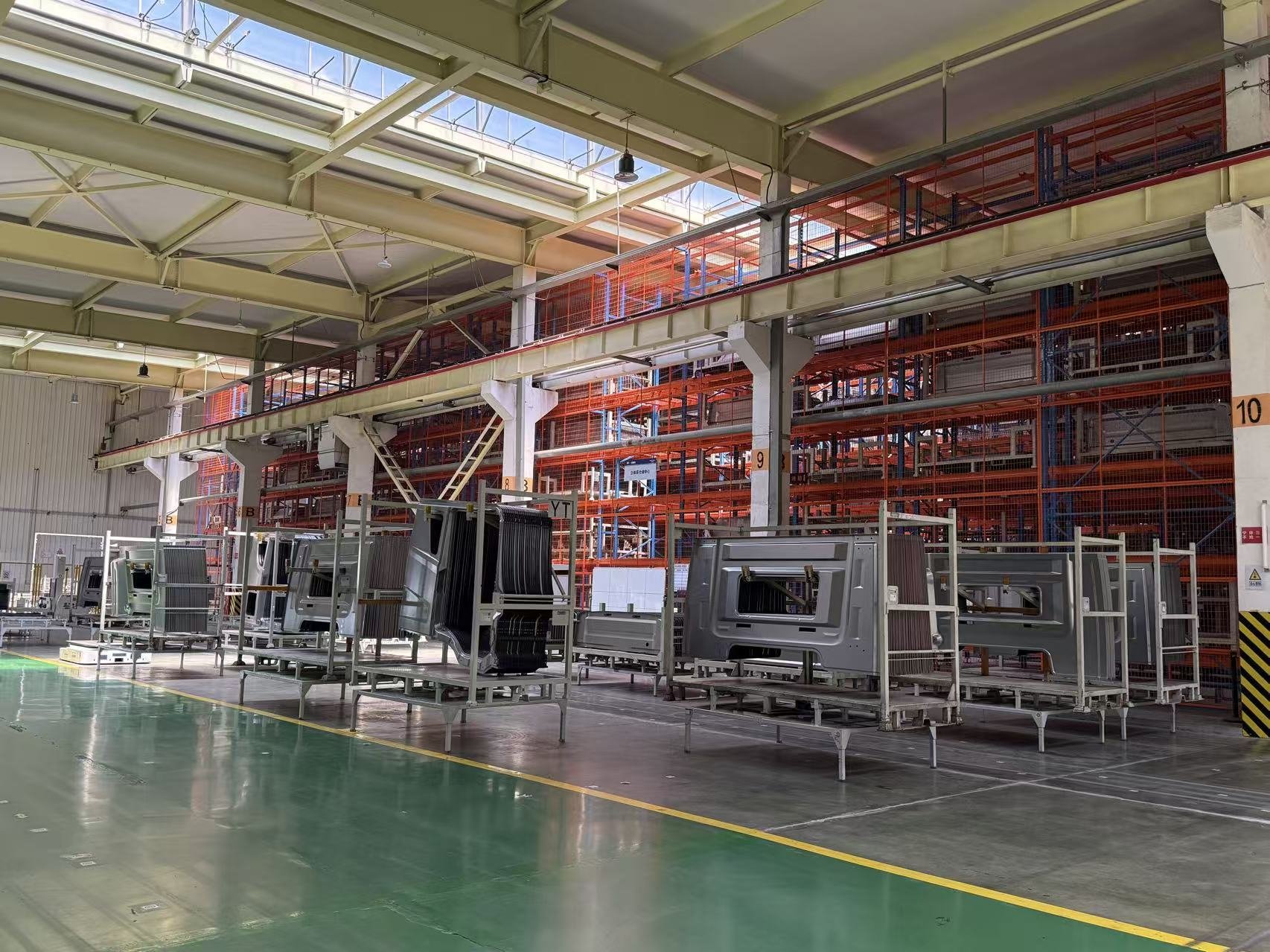

II. First Stop: Stamping Shop – Turning Steel into "Skeleton"
![]()
The first step in truck manufacturing starts with coils of steel plate.
Process Flow:
Uncoiling: Opening and flattening the steel plate coils
Blank Cutting: Cutting into appropriately sized steel plates for stamping
Stamping: Using large stamping presses to form the steel plates into various cab sheet metal parts (doors, side panels, roof, etc.)
Technical Highlights:
Stamping presses can reach 7,000 tons, completing multiple steps in one stroke
Hole position tolerance is controlled within 0.2mm
Dies are the core—a mature, high-quality die set takes over six months to develop and costs hundreds of millions of RMB
High-strength steel is used to ensure cab safety in collisions

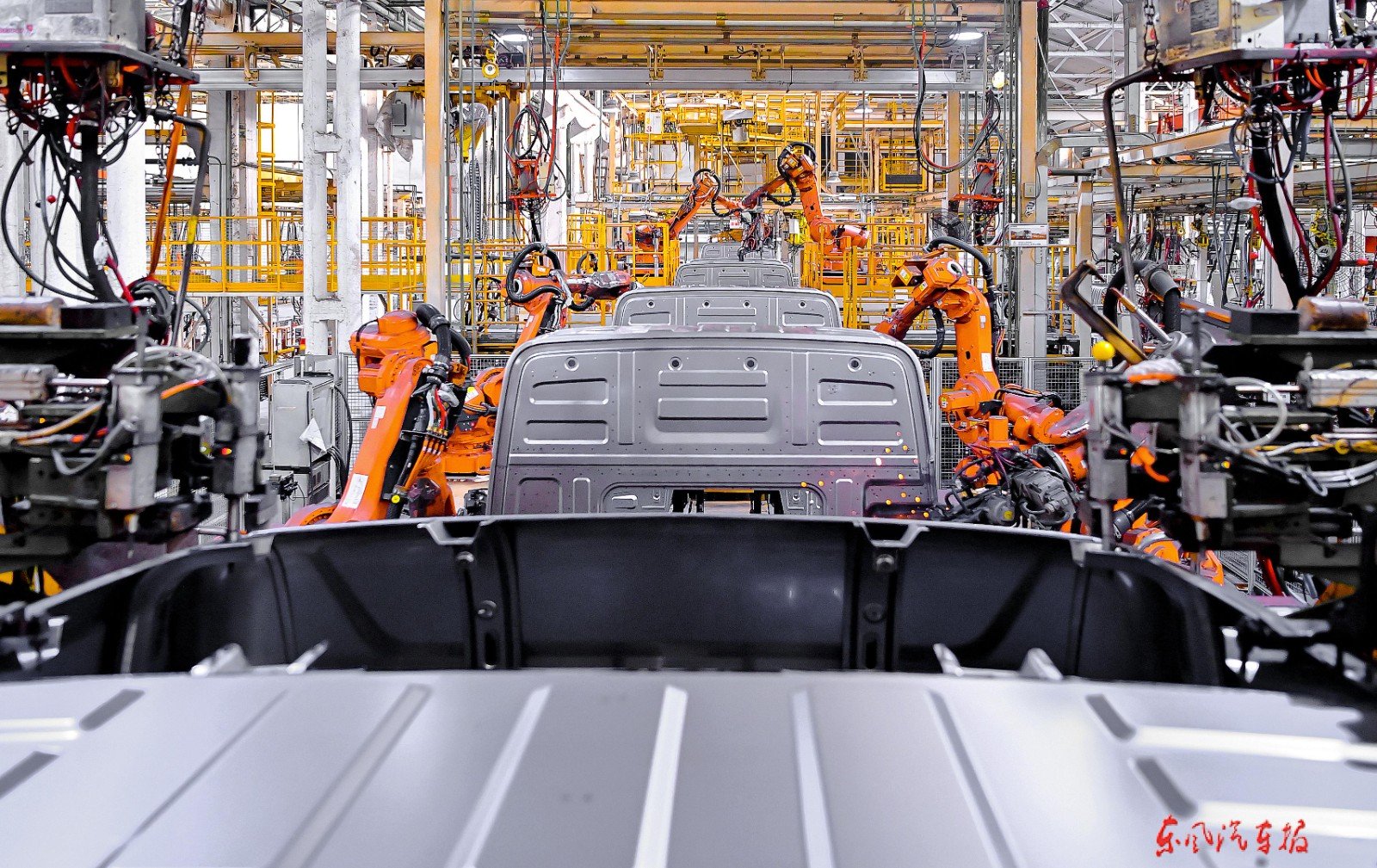

III. Second Stop: Welding Shop – The "Steel Tailor"
![]()
The stamped sheet metal parts are welded together in the welding shop to form a complete cab. This unfinished cab is called the "body-in-white."
Process Flow:
Sub-assembly Welding: Welding floor assembly, left side panel, right side panel, front panel, rear panel, roof, etc., separately
Main Body Welding: Assembling all sub-assemblies on the welding line to form the complete cab
Door Welding & Installation: Welding doors on a separate line and installing them onto the cab
Precision Inspection: Using coordinate measuring machines to monitor key points and ensure accuracy (some manufacturers achieve 0.3mm precision)
Technical Highlights:
Advanced factories in China have achieved 100% robotic welding; for example, SINOTRUK's Laiwu factory has 100% automation for weld points
Welding robots complete one weld point every 4 seconds, compared to 8 seconds for manual welding
The welding shop requires minimal workers—SINOTRUK's Laiwu factory has 223 robots managed by just 5 workers, reducing labor needs to 1/80 of traditional levels
Flexible production lines can produce multiple models simultaneously—SINOTRUK achieves flexible co-production across 3 platforms and 75 cab variants
AI vision inspection systems can determine whether a weld point is qualified within 0.1 seconds

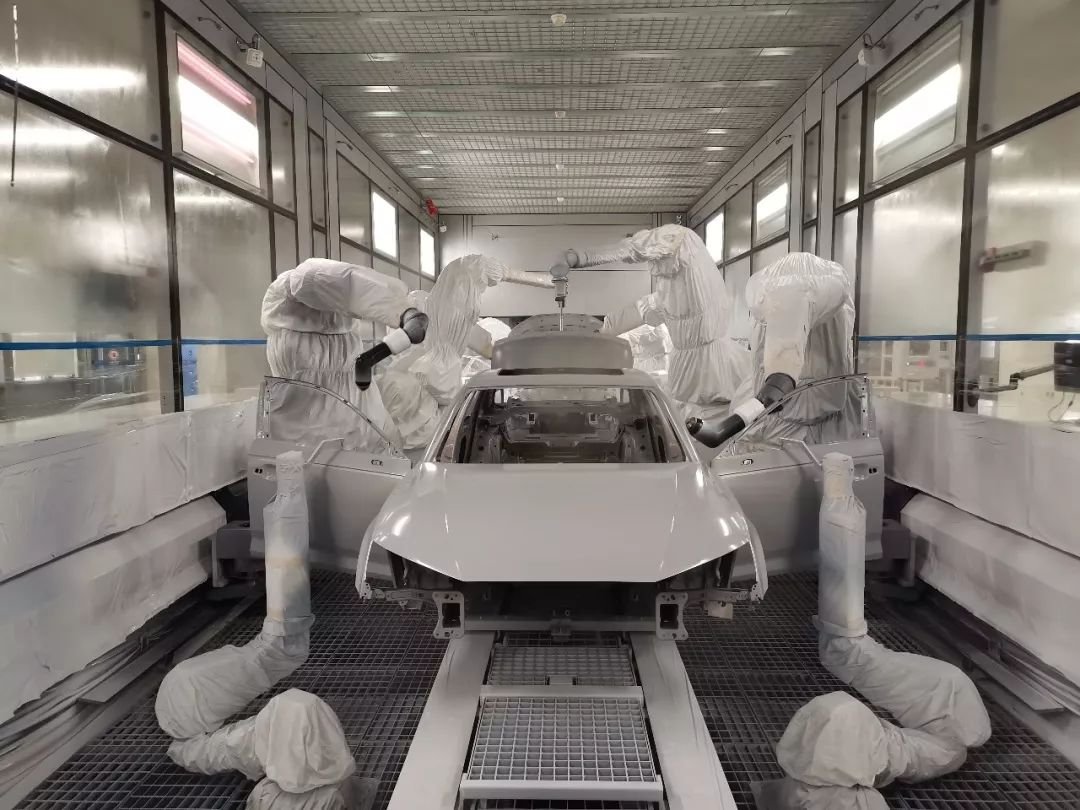

IV. Third Stop: Painting Shop – Giving the Cab Its "Armor"
![]()
The welded body-in-white undergoes a complex painting process to achieve corrosion protection, rust resistance, and an attractive finish.
Process Flow:
Pretreatment/Cleaning: Rust removal, residue cleaning, debris removal, followed by multiple stages of water washing (some manufacturers use 10 washing stages)
Electrophoresis: Immersing the entire cab in an electrophoresis tank to form a dense primer coating on the metal surface—this is the key to rust prevention
Drying: Drying in an oven at 200°C
Sealant Application: Applying sealant to all welds, inside and out, to ensure sealing and sound insulation
Spray Painting: Robots apply intermediate coat, topcoat, clear coat, and other layers
Final Drying: Drying after each coating layer
Technical Highlights:
Advanced painting shops have no paint smell—fully enclosed automated spraying systems reduce VOC emissions by 40%
The three-coat, three-bake process ensures a smooth, uniform finish
The electrophoretic primer provides excellent corrosion resistance, ensuring the cab won't easily rust even in coastal areas
Heat recovery systems can reclaim 95% of waste heat
V. Fourth Stop: Final Assembly Shop – Where the Truck Is Born
![]()
The painted cab, along with the frame, powertrain, and other components, undergoes final assembly in the final assembly shop. This is where a complete truck is born.
Process Flow :
Frame Assembly: Assembling the frame from longitudinal and cross beams; each frame is assigned a chassis number (17-digit code) that guides every subsequent step
Cable and Harness Installation: Routing and connecting electrical cables and air lines
Suspension and Axle Installation: Installing suspension, front axle, middle axle, and rear axle
Frame Flipping: Flipping the frame to facilitate underbody component installation
Powertrain Installation: Engine and transmission are assembled on a sub-line, then hoisted onto the chassis

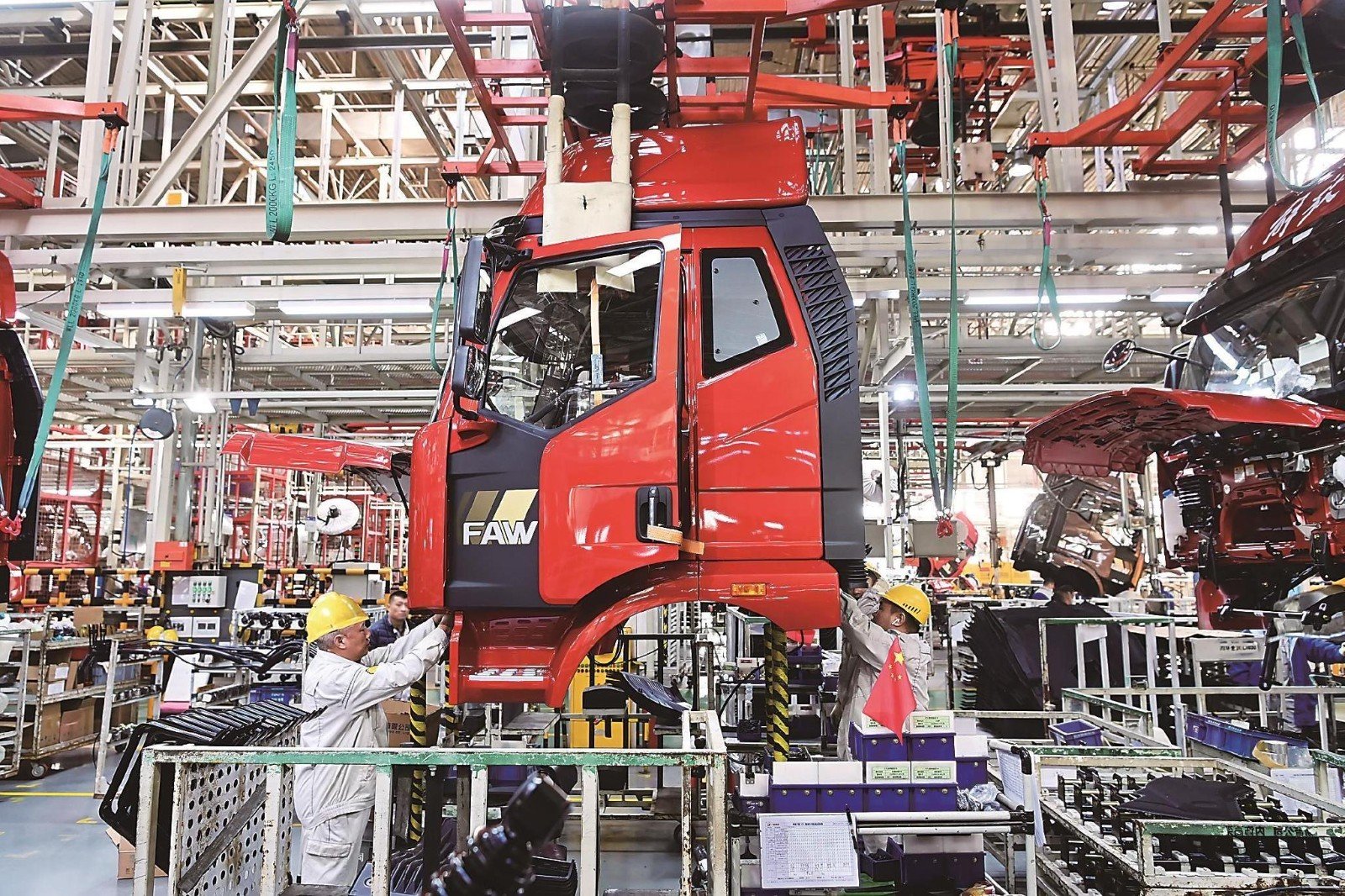

Cab Installation: Hoisting the painted cab onto the chassis
Tire Installation: Installing tires using robotic arms or manually
Fluid Filling: Automatically filling fuel, engine oil, coolant, etc.
Quality Inspection & Testing: Roller testing, computer calibration, road testing, etc.
Technical Highlights:
Assembly lines can stretch up to 800 meters, with a single line capable of assembling 180 trucks per day
Leading factories in China can achieve flexible co-production of 6 different models on the same line
AGVs (Automated Guided Vehicles) replace traditional conveyor belts, offering greater flexibility for flexible production
Each workstation has a quality checklist that must be signed off by the team leader before moving to the next step
The white markings on engine oil pipes and water pipes are used for precise positioning—clamps must align exactly with the markings to ensure proper installation
VI. Quality Inspection – The Final Gate Before Delivery
After final assembly, every truck undergoes rigorous testing before leaving the factory:
Static Inspection: Checking all assembly points, cables, bolt torque, etc.
Water Leak Test: Simulating heavy rain to test cab sealing
Roller Test: Simulating driving conditions to test the powertrain
Dynamic Road Test: Actual road testing on complex test tracks within the factory grounds
Only after passing all tests is a brand new truck officially ready to be delivered to the customer.
